SP Energy 2026 works

Event
SP Energy 2026 works
Event start date
Duration
6 months

Planned work as at 28/02/2026 - dates may change as the schedule progresses.

All work is planned by SP Energy, using the Contractor Opus Energy:

"We currently have two teams working simultaneously on the project in different areas of Lymm. The work is being completed in stages with the aim of keeping disruption to a minimum. We have an on-site manager who will be in the area for the duration of the project during scheduled hours."

The chart below has been put together from the SP Energy dates here: www.spenergynetworks.co.uk/lymm & is 'correct' as at 28/02/2026 - the overlapping dates are believed correct, though the chart below has public holidays set to non-working days, so work days may differ slightly. The hashed column is LHS Easter Holidays.

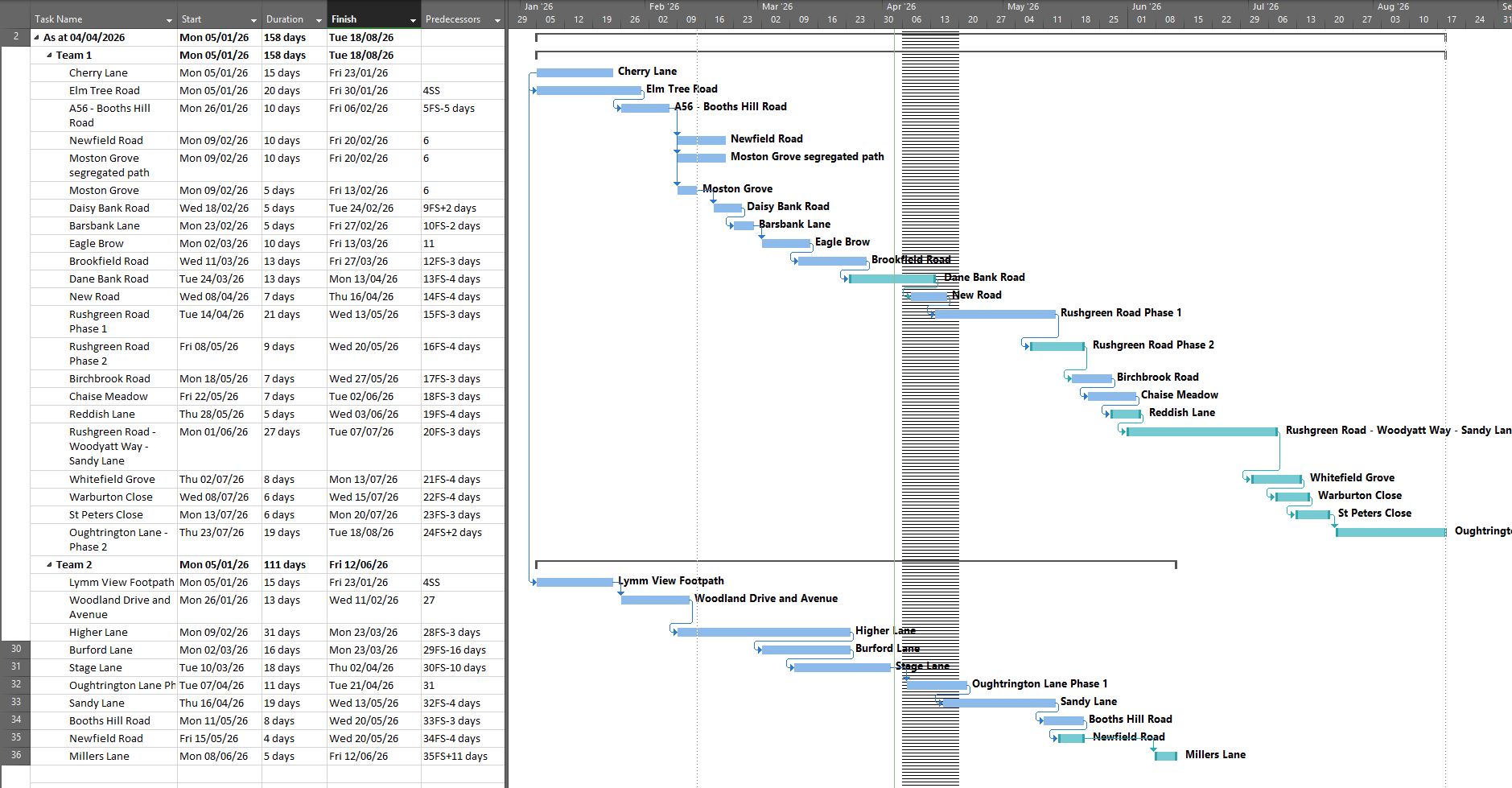

2026.02.25 SP Energy Gantt
